Skip to main content
24 / 7 Emergency Response Active
Cost & ProcessSeptember 18, 202611 min read

Deposits and Progress Billing: How Florida Restoration Companies Get Paid

BY RESTORATION DOCTOR OF MIAMI · MIAMI-DADE, BROWARD & PALM BEACH

Work authorization on a clipboard beside a pen on a kitchen counter at night in a South Florida home.
A signed work authorization is the document the deposit and the billing schedule sit in.
TL;DR

A water loss has four money moments: the work authorization, any deposit, the mitigation invoice and the reconstruction draw schedule. They are not the same contract and not the same timeline, so read what the paper actually commits you to before the equipment comes off the truck.

Call (786) 213-9489

Do restoration companies require a deposit in Florida?

Some do and some do not, and a Florida restoration company deposit is not automatically a warning sign on its own. What matters is the size of the request, what it is attached to in writing, and whether it arrives before or after somebody has actually scoped the loss. A modest mobilization payment against a written emergency scope reads very differently from a large cash demand made at the door with nothing on paper.

On the emergency side, many companies in Miami-Dade, Broward and Palm Beach take nothing up front and invoice once the structure is dry. Others ask for a deposit covering the first mobilization: crew, truck, extraction, equipment set. On the rebuild side, staged payments are normal across the construction trade, because the contractor buys materials and books subcontractors first.

Florida law also attaches duties to the money you hand over at the start. The state statute on moneys received by contractors sets duties that attach to an initial payment of more than 10 percent of the contract price on residential repair or restoration work, which is how a mitigation-and-rebuild scope is normally treated. The contractor has to apply for any necessary permits within 30 days of taking the payment. It then has to start the work within 90 days after those permits are issued. The practical read for a homeowner is simple: a deposit is supposed to start a job, not park your money.

What am I actually signing in a work authorization?

A work authorization is permission plus a promise. It gives the company the right to enter, open wet assemblies, remove unsalvageable material and place drying equipment, and it makes you responsible for paying for that work. It is usually not a price. On an emergency loss nobody knows the full quantity of wet drywall or the number of equipment days on night one, so the authorization sets the terms and the pricing basis while the scope fills in as the job runs.

That is the part worth slowing down on at the kitchen counter. An authorization that names the phase, the pricing basis and the cancellation terms is doing its job. An authorization that leaves the phase open, or that quietly reaches past mitigation into the rebuild, is committing you to something much larger than the drying equipment in your hallway.

  • The phase it covers: emergency mitigation only, or mitigation plus reconstruction. These should be separate signatures.
  • The pricing basis: line item pricing from a recognized estimating platform, a published rate sheet, or time and materials. Any of the three can be fair. Silence is not.
  • Who is responsible for payment: the property owner signs and the property owner owes, regardless of what the claim eventually pays.
  • Any deposit amount, written as a number, and what it is credited against.
  • Cancellation and rescission terms, including how you stop work and what you owe for work already performed.
Technician photographing an equipment layout on a tablet in a tiled, emptied Miami room during drying.
Equipment days are the line items that build the mitigation invoice.

When does money change hands: the four moments on a water loss?

There are four points on a typical South Florida water loss where money is discussed, and they are frequently confused with each other. Separating them is the single most useful thing a homeowner can do on night one. The table below is the sequence in plain order, with what each moment is actually for.

The authorization is a commitment without a total. The deposit, if there is one, is a payment against work not yet performed. The mitigation invoice is a bill for work already completed and documented. The reconstruction draws are a schedule you negotiate before the rebuild starts, not after.

  • Moment one commits you. Moment two funds the start. Moment three bills completed emergency work. Moment four is a construction contract with its own terms.
MomentWhat it is forTypical timingWhat should be in writing
Work authorizationPermission to begin emergency work and your agreement to pay for itNight one, before extraction startsPhase covered, pricing basis, cancellation terms, deposit amount if any
Deposit or mobilization paymentCrew, truck, initial equipment set and materials on the emergency scopeAt or shortly after authorization, where the company asks for oneA stated amount, what it is credited against, and refund terms
Mitigation invoiceExtraction, demolition, containment, equipment days and monitored drying, billed after the factAfter drying is verified complete and equipment is pulledLine item scope, moisture logs, equipment placement and removal dates, photos
Reconstruction contract and drawsPutting the building back: drywall, flooring, cabinetry, paint, trimA separate agreement signed after mitigation, with staged paymentsFixed scope, allowance amounts, draw schedule tied to milestones, change order process
General sequence on a residential water loss in South Florida. Your contract governs, and a condo association or lender can add steps.

What is the difference between the mitigation invoice and the rebuild contract?

Mitigation and reconstruction are two different jobs with two different billing logics, and treating them as one contract is where most payment confusion starts. Mitigation is emergency service work: extraction, controlled demolition of unsalvageable material, containment, antimicrobial application, air movers and dehumidifiers running until the structure meets a documented dry standard under the IICRC S500. It is billed after the work is done, usually as line items with quantities, because nobody can know the quantities in advance.

Reconstruction is construction. It has a defined scope, a fixed or allowance based price, permits where the work requires them, and a payment schedule tied to milestones. A rebuild in a Coral Gables house and one in a Brickell high rise price differently, because the building adds requirements: approved vendor lists, certificates of insurance, elevator reservations, restricted work hours.

The two invoices should also read differently. A mitigation invoice is a record of what happened, so it carries equipment days, moisture readings and dated photographs. A reconstruction invoice is a record of what was installed. For a line by line walk through of what belongs on the emergency bill, our sister site in the Restoration Doctor network covers how to read a mitigation invoice at https://restorationdoctors.com/blog/how-to-read-a-water-mitigation-invoice. The same structure applies to a South Florida job.

Signing a mitigation authorization does not obligate you to use the same company for the rebuild, unless the paper you signed says it does. Read for that clause specifically.

How does an insurance claim change the payment timing?

A claim changes when money arrives, not who owes it. You hired the contractor, so the contractor invoices you, and the carrier reimburses under your policy on its own schedule. Restoration Doctor works that way in South Florida: we bill you, the homeowner, and hand you a carrier-ready claim file with a line item scope, photo documentation and daily moisture logs.

The timing gap is the real problem. Emergency work happens in the first hours. The first claim payment usually lands weeks later, and it is normally actual cash value rather than the full replacement cost, with depreciation held back until the work is finished and invoiced. Your deductible comes out of that payment as well, and your policy's declarations page will state whether the hurricane deductible is a percentage of the dwelling limit or a flat amount.

Two more parties can sit between the check and the contractor. If you carry a mortgage, the lender is often named on the building portion of the payment and releases funds in stages after inspections. If you live in a condominium, the association master policy and your unit policy each settle on their own track, which can leave a unit owner paying an emergency invoice long before either policy pays out. Plan the sequence early rather than discovering it when the first invoice is due.

  • The contract is between you and the contractor. The claim is between you and the carrier. Two agreements, two timelines.
  • Ask the company how it handles the gap between the invoice date and the carrier payment, and get the answer in writing.
  • If the claim stalls on the merits rather than the paperwork, a licensed public adjuster or an attorney is the right professional to bring in. A restoration contractor cannot negotiate the claim for you.

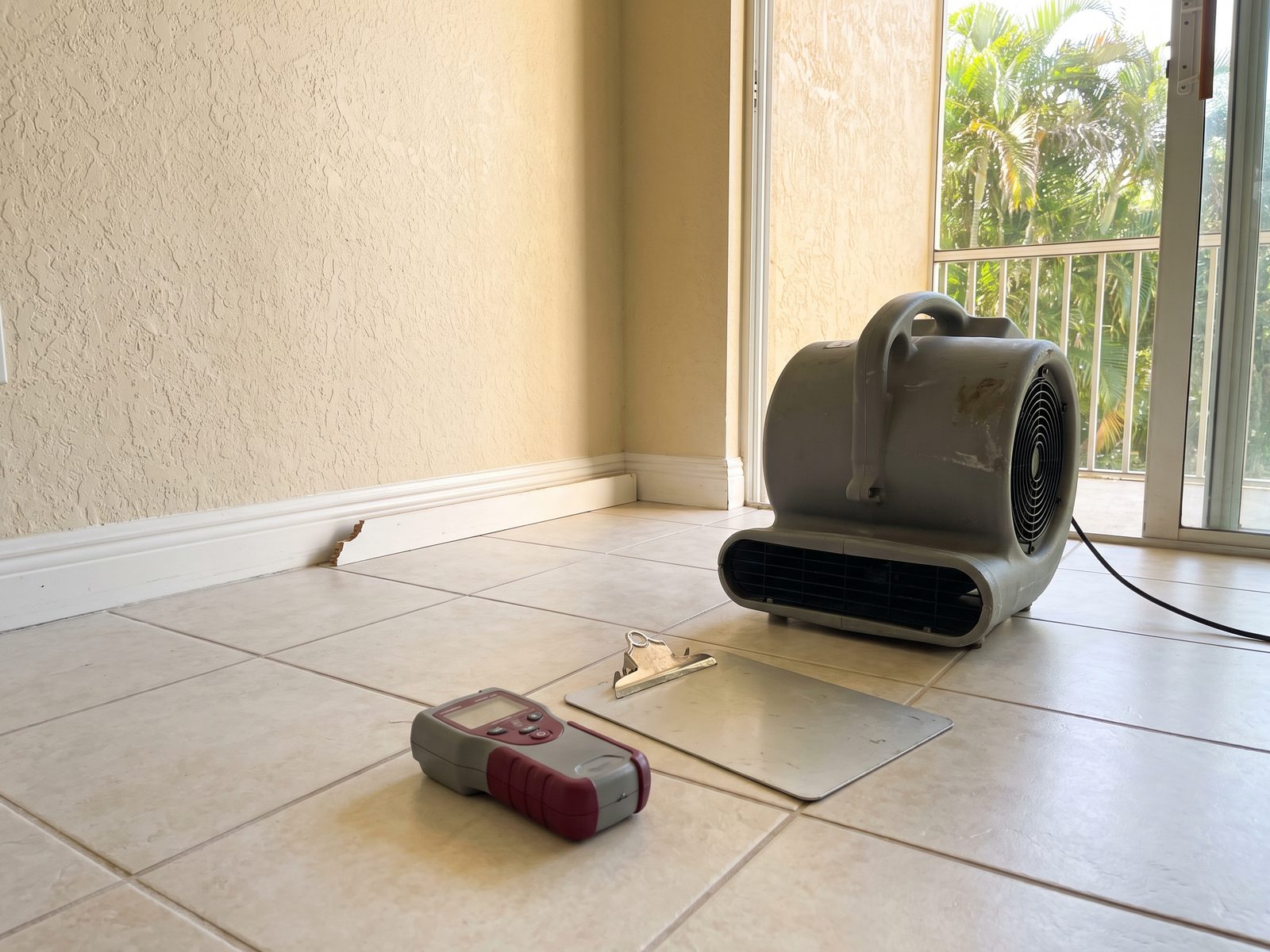

Moisture meter and a clipboard on a tiled floor beside a grey air mover in a sunlit South Florida room.
The readings and equipment days behind each line item are what make an invoice checkable.

What is an assignment of benefits, and what changed in Florida law?

An assignment of benefits, usually shortened to AOB, is a document that transfers your post loss insurance benefits to the contractor, so the contractor pursues payment from the carrier directly and you step out of that transaction. For years this was routine on Florida property losses, and a payment structure that looked normal here five years ago is now a reason to stop and read.

Florida changed the rules. The assignment agreement statute, section 627.7152 of the Florida Statutes, sets out what an assignment agreement had to contain for policies issued from July 1, 2019 up to January 1, 2023. The required items include a written itemized cost estimate, a rescission right, delivery of the signed agreement to the insurer within three business days, and a bold face warning notice. The same statute then turns to newer policies. For residential and commercial property policies issued on or after January 1, 2023, a policyholder may not assign post loss benefits in whole or in part. An attempt to do so is void, invalid and unenforceable. A few narrow situations sit outside that rule, and a contractor taking assignment of your claim is not one of them.

This is a high level description, not legal advice, and the statute link is in the sources below so you can read the text yourself. The practical point for a homeowner in Miami or Hollywood is narrow and useful. If a contractor hands you a document at 2am that signs your claim benefits over to the company, ask what policy date it is written against. Ask why the company needs it at all. On a current policy that structure does not do what the contractor may think it does.

Which payment requests are genuine red flags?

Most restoration companies working after a storm are legitimate operators doing hard work in bad conditions. The structures below are still worth questioning, because they shift risk onto the property owner in ways that are difficult to reverse once money has moved.

None of these is proof of anything by itself. Taken together, or presented with pressure and a pen at midnight, they are a reason to pause and call a second company.

  • A large cash payment demanded before anyone has scoped the loss or put a written emergency scope in your hand.
  • A deposit that is a percentage of the whole projected claim rather than a stated amount tied to the emergency scope.
  • A request to endorse the carrier check over to the company before any work is documented or invoiced.
  • Pressure to sign in the driveway, with no copy left behind and no time to read.
  • Refusal to provide an itemized invoice, or an invoice that shows a single lump sum for the entire mitigation phase.
  • A promise that the company can make the deductible disappear, which is a claim no contractor should be making.

What should never appear on a work authorization?

A few clauses turn a routine emergency document into something much heavier. If you find one of these, that is the moment to ask for a plain explanation, and to ask for it before you sign rather than after the equipment is running.

  • A blank dollar amount, a blank scope line, or blank spaces anywhere you are asked to initial.
  • Open ended authorization for all work deemed necessary, with no phase limit and no ceiling.
  • An assignment of post loss insurance benefits, which the Florida statute now addresses directly for policies issued on or after January 1, 2023.
  • A clause appointing the company to negotiate or settle your claim, which is work Florida reserves for licensed public adjusters and attorneys.
  • An automatic tie in requiring you to use the same company for reconstruction.
  • A term stating you owe whatever the carrier does not pay, attached to a scope that has no stated limit.
Open folder of paperwork beside a closed laptop on a wooden table in a Florida home with tile flooring.
Mitigation and reconstruction are separate invoices for a reason.

What questions should I ask before signing at 2am?

You are tired, the floor is wet, and a crew is at your door ready to work. The goal is not to negotiate a construction contract in the dark. It is to answer a short list of questions in five minutes, so the work starts and the money stays clear.

Write the answers on the authorization itself if there is room. A note in the margin, initialed by both of you, is worth more later than anyone's memory of what was said in the hallway.

  • 1. Is this authorization for emergency mitigation only, or does it cover reconstruction too?
  • 2. Do you require a deposit tonight, and if so, what exactly is it credited against?
  • 3. How is the work priced: a recognized estimating platform, a rate sheet, or time and materials?
  • 4. When will I get the invoice, and what documentation comes with it?
  • 5. Do you monitor the equipment daily, and will I get the moisture readings?
  • 6. Am I obligated to use your company for the rebuild?
  • 7. Does this document assign my insurance benefits to you in any way?
  • 8. Can I have a signed copy before you leave tonight?

Where can I read the Florida rules myself?

Everything above describes how the process works, and none of it is legal advice. The primary sources are public, and reading them before a pen reaches a kitchen counter is the cheapest protection a property owner has.

  • Sources: Florida Statutes section 489.126, moneys received by contractors: https://www.flsenate.gov/Laws/Statutes/2026/489.126
  • Florida Statutes section 627.7152, assignment agreements: https://www.flsenate.gov/Laws/Statutes/2026/627.7152
  • Florida Statutes section 626.854, public adjusters, including the limits on what a licensed contractor may do with a claim: https://www.flsenate.gov/Laws/Statutes/2026/626.854
  • IICRC standards, including the S500 Standard for Professional Water Damage Restoration: https://iicrc.org/iicrcstandards/
